Mainframe Modernization on AWS: What the Cutover Costs
- LAST UPDATED
- 32 min read
Key takeaways
- Total program cost is the build plus the cutover. At the bank in this guide, the cutover adds about $2.6 million to a $6.0 million build, and most proposals would leave it out.
- The code conversion line has shrunk. Since March 2026, AWS hasn't charged for refactoring the code itself, and the money you'd have spent there is better spent on testing and data parity.
- Month-end is where hidden logic shows up. A deposit system that matched for two quiet weeks can still break on its first month-end close, so the parallel run has to cover one.
- The rollback plan is also a compliance document. A US bank examiner and an EU supervisor will both ask to see the way back, and they'll want to know it's been tested.
- Fixed-date, fixed-fee terms are only as good as their delay clause. It has to say who pays when a date slips and how each phase gets signed off.
Quick answer
Mainframe modernization on AWS doesn't usually go wrong in the planning sessions. It goes wrong in the weeks between the last test cycle and the morning your branches, claims desks, or plant floors start running on the new stack. That's when two platforms run side by side, release freezes hold the business back, and every reconciliation break waits on someone with the authority to sign it off, so that's when budgets swell.
We've been building regulated systems on AWS since 2008: payment platforms that answer to PCI DSS assessors, claims platforms that answer to HIPAA, and agent-driven workflows that have to explain every decision to an auditor. When we're asked to rescue or price a mainframe program, we nearly always find the same thing. The code conversion has been estimated down to the line, and the cutover has been ballparked, even though the cutover is where the money and the risk sit.
We'll use one made-up but typical company to keep the numbers honest: a US regional bank whose deposits, consumer loans, and general ledger still run on a z/OS mainframe. There are about 4 million lines of COBOL behind them, some 2,500 batch jobs every night, and data split between Db2 for z/OS and VSAM files. Keeping it all running costs $9.6 million a year, and the hardware lease and two big ISV contracts renew in 20 months, which makes that the real deadline. Debit cards bring PCI DSS into scope, and because the bank is listed, SOX applies too.
If you're the one taking that number to the board, the bank's case shows where it usually goes wrong and what to ask for instead.
What does mainframe modernization on AWS cost once cutover is included?
Four things drive the cost of mainframe modernization on AWS. Two are about size: MIPS and lines of code. Two are choices you make: the path for each application and how many cutover waves you run. Then there's the one budgets tend to guess at, which is how long both platforms run side by side. Get that guess wrong, or skimp on reconciliation and hypercare, and the program comes back with a change order.
|
Cost layer |
What it covers at the bank |
Why it gets underpriced |
How we'd price it |
|---|---|---|---|
|
Build: discovery and assessment |
Taking stock of 4 million lines of COBOL and untangling the scheduler that runs 2,500 jobs a night |
"The documentation's current." |
A fixed price, scoped from what automated discovery finds |
|
Build: code transformation |
COBOL, PL/I, and a few hundred Assembler routines converted or rewritten |
"The tool price covers it." The edge-case rework turns up in testing. |
Per application, each one tied to its own equivalence tests |
|
Build: data migration engineering |
Db2 for z/OS and VSAM data moved to relational targets, with EBCDIC and packed decimal conversion |
"We'll load it once." |
Per data domain, with the reconciliation priced in |
|
Build: test harness and regression |
Test case capture, automated comparison, batch replay |
Test data is scarce and subject-matter experts are booked |
Fixed, with test ownership named in the contract |
|
Cutover: dual running |
Three months of AWS at production scale while the mainframe keeps running alongside it |
Parallel run length is guessed |
Per month, sized by business cycles |
|
Cutover: change freeze |
Deferred releases and business changes held during cutover |
Nobody books the opportunity cost |
Agreed freeze calendar, priced by the business owner |
|
Cutover: reconciliation and sign-off |
Output diffing, break triage, business acceptance |
Business staff time sits outside IT budgets |
Per cycle, with named approvers |
|
Cutover: hypercare |
Elevated support, on-call engineers, performance tuning after go-live |
Assumed to be "just support" |
Fixed window with exit criteria |
|
Cutover: rollback reserve |
Mainframe contract extension and reverse synchronization if a wave fails |
Treated as unthinkable until it happens |
Reserve equal to at least one month of mainframe run cost |
The cutover ledger deserves this much attention because downtime is expensive. Splunk's 2026 study with Oxford Economics put unplanned downtime for Global 2000 companies at $15,000 per minute on average. Four extra hours on a cutover weekend would cost $3.6 million at that rate, which is more than most programs budget for hypercare.
When one firm prices the build and another inherits the go-live, the cutover tends to fall between the two contracts, and nobody owns the overrun. So our legacy software modernization engagements put the cutover and the legacy switch-off in the same fixed-fee scope as the build.

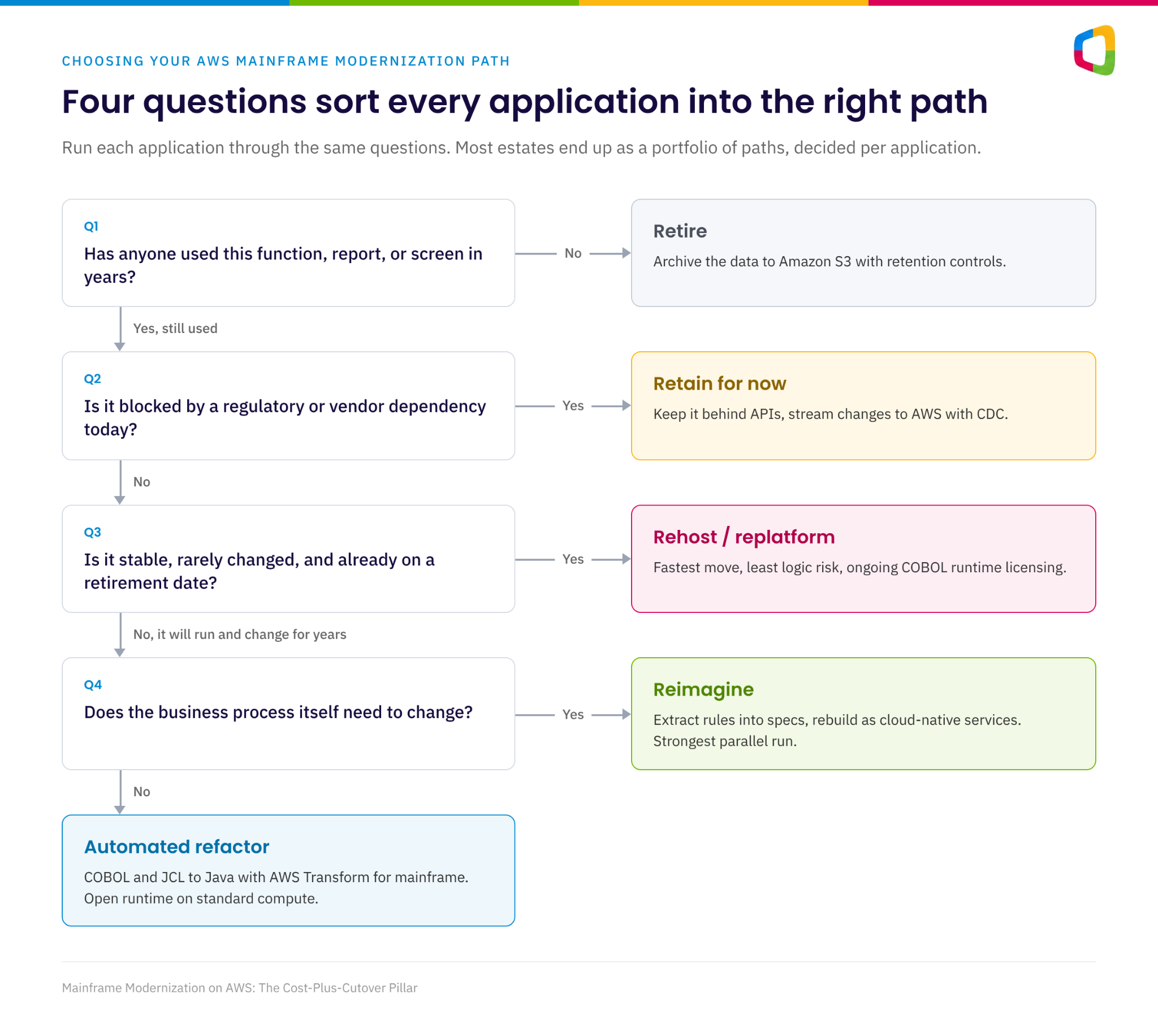

Which AWS mainframe modernization path fits your estate: rehost, replatform, refactor, or reimagine?
There isn't one path for the whole estate. You choose per application, based on how much its business logic has to change and how long you plan to keep it. In the estates we assess, that usually leaves a few workloads refactored, a few reimagined, some retired outright, and a small set replatformed to buy time.
|
Path |
What changes |
Typical AWS tooling |
Cost profile |
Cutover risk |
Best fit |
|---|---|---|---|---|---|
|
Rehost / replatform |
COBOL stays COBOL and moves to a compatible runtime on Amazon EC2 |
Commercial COBOL runtimes licensed from the runtime vendor |
Lower build cost, ongoing runtime licensing |
Lower, since logic is untouched |
Stable systems with a planned retirement date |
|
Automated refactor |
COBOL and JCL converted to Java, data moved to relational stores |
AWS Transform for mainframe refactor (formerly AWS Blu Insights) |
Moderate build cost, open runtime on standard compute |
Moderate, driven by test coverage |
Core systems you plan to run for a decade |
|
Reimagine |
Business rules extracted into specifications and rebuilt as cloud-native services |
AWS Transform for mainframe reimagine, plus modern engineering teams |
Higher build cost, lowest long-term run cost |
Higher, requires the strongest parallel run |
Systems where the business process itself needs to change |
|
Retire |
Function absorbed by SaaS or an existing platform |
Data archival to Amazon S3 with retention controls |
Lowest |
Low, mostly data retention |
Reports and screens nobody has opened in years |
|
Retain (for now) |
Stays on the mainframe, with APIs in front of it |
Change data capture streams its data to AWS for analytics and AI |
Low now, with the cost deferred |
None for now |
Workloads held back by a regulatory or vendor dependency |
At the bank, deposits and consumer loans would go to automated refactor, since the bank expects to run and change them for another decade. Loan origination, which the business wants to redesign anyway, would be reimagined. About 300 regulatory reports that nobody opens anymore would be retired, with their data archived to Amazon S3. The debit card system would stay put for now, behind APIs, because its processor contract runs another three years, and its data would stream to AWS through change data capture.
When you sort the portfolio, look at how often each application changes. If it changes often, refactoring or reimagining it starts to pay off. Code nobody has touched in ten years, with fewer users every year, rarely justifies a rewrite.
Ask two more questions now, or you'll be asking them in hindsight. First, which applications share data stores or batch chains, since they'll have to move in the same wave? (At the bank, that's the general ledger and the deposit system, which share a nightly batch chain.) Second, is anything tied to an exam, an audit, or a contract deadline that fixes the cutover window no matter what the engineers say?

What changed in the AWS mainframe toolchain, and how does it move your budget?
Until March 2026, refactoring a mainframe with AWS's tooling meant paying by the line of code. Now AWS Transform for mainframe refactor offers code transformation at no cost, and AI agents handle much of the analysis and planning that analysts used to bill for. That money hasn't vanished from the budget. It's moved to testing, data parity, the cutover, and the engineers who make the calls that hold it all together.
|
What changed |
What it means for your budget |
What it means for your cutover |
|---|---|---|
|
AI agents in AWS Transform for mainframe handle code analysis, documentation, decomposition, wave planning, and refactoring |
Discovery and planning shrink from months of analyst time to weeks |
You get wave plans earlier, so there's more time to agree freeze calendars with the business |
|
Refactor's code transformation (formerly AWS Blu Insights) is free now, instead of priced by lines of code, though the runtime is still billed |
The conversion line shrinks, and fixing edge cases becomes the real build cost |
There's money for a longer parallel run with better instrumentation |
|
Reimagine workflows trace each extracted requirement back to source code |
Business-rule extraction becomes auditable instead of tribal |
Auditors and business owners can sign off on equivalence with evidence |
|
Automated testing, launched with support for IBM z/OS batch applications |
Test generation costs fall |
Batch reconciliation can run nightly during the parallel run |
|
AWS Mainframe Modernization's self-managed experience and Managed Runtime Environment experience no longer take new customers |
Replatform plans built on those options need a different runtime route |
Programs planned on older AWS guidance should revisit their target architecture before signing |
The practical takeaway for a CFO: a proposal that still carries a large, opaque line for "code conversion" deserves a hard second look. Ask what the tool costs, what the remediation costs, and what the validation costs, as three separate numbers.
Two smaller changes matter for the run budget. AWS's pricing page lists the refactor runtime at $0.31 per AWS CPU core per hour, so the converted code still has a running cost. And if an older plan relied on AWS's own runtime for a replatform, those AWS Mainframe Modernization options no longer accept new customers, so the runtime has to come from the vendor directly.
We see the same shift in database work. On our application and database modernization programs, the savings from automated conversion are only real when the freed-up budget goes into validation and a clean cutover. Programs that pocket the savings and trim the test phase tend to give it all back during hypercare.
How do you build a mainframe migration to AWS cost model that survives CFO review?
A mainframe migration to AWS cost model survives CFO review when it prices the cutover as explicitly as the build and shows what each month of delay costs. We call this the Cost-Plus-Cutover model. It is the same arithmetic we put in front of finance teams before any statement of work is signed.
Total program cost = Build + (D × m) + F + R + H + B
D is what AWS costs each month at production scale while the parallel run lasts, and m is how many months it lasts. The mainframe bill isn't in there, because you're paying it until the exit date anyway. F is the cost of the change freeze, R covers reconciliation and business sign-off, H is hypercare, and B is the rollback reserve.
Finance and engineering have to agree on the inputs before anyone fills it in:
- Peak and average MIPS or MSU consumption, plus the monthly license charges and ISV contracts tied to them
- Renewal and notice dates for every mainframe contract, since these set your real deadline (for the bank, the hardware lease and two ISV renewals 20 months out)
- Batch windows, scheduler dependencies, and the downstream files other systems expect
- Data volumes for every store, along with the retention and residency rules each one falls under
- Regulatory events and blackout dates: quarter-end close and exam dates for a bank, open enrollment for a health plan, peak weekends for a retailer

Here's how it works out for the bank, with its $9.6 million annual run cost, a $6.0 million build, and a three-month parallel run.

The ratio matters more than the absolute numbers. At the bank, the cutover ledger adds roughly 43% to the build, and the single largest cutover line is the rollback reserve, equal to one month of mainframe run cost.
Then run the sensitivity that most proposals skip. If the mainframe exit slips one month past the contract date, the bank pays another $0.8 million in mainframe run cost plus a month of team burn. Let it slip three months and the bank has paid $2.4 million before counting the team, which is 40% of the whole build budget. That's why we put the exit date in the contract as part of our delivery commitment, not as a target.

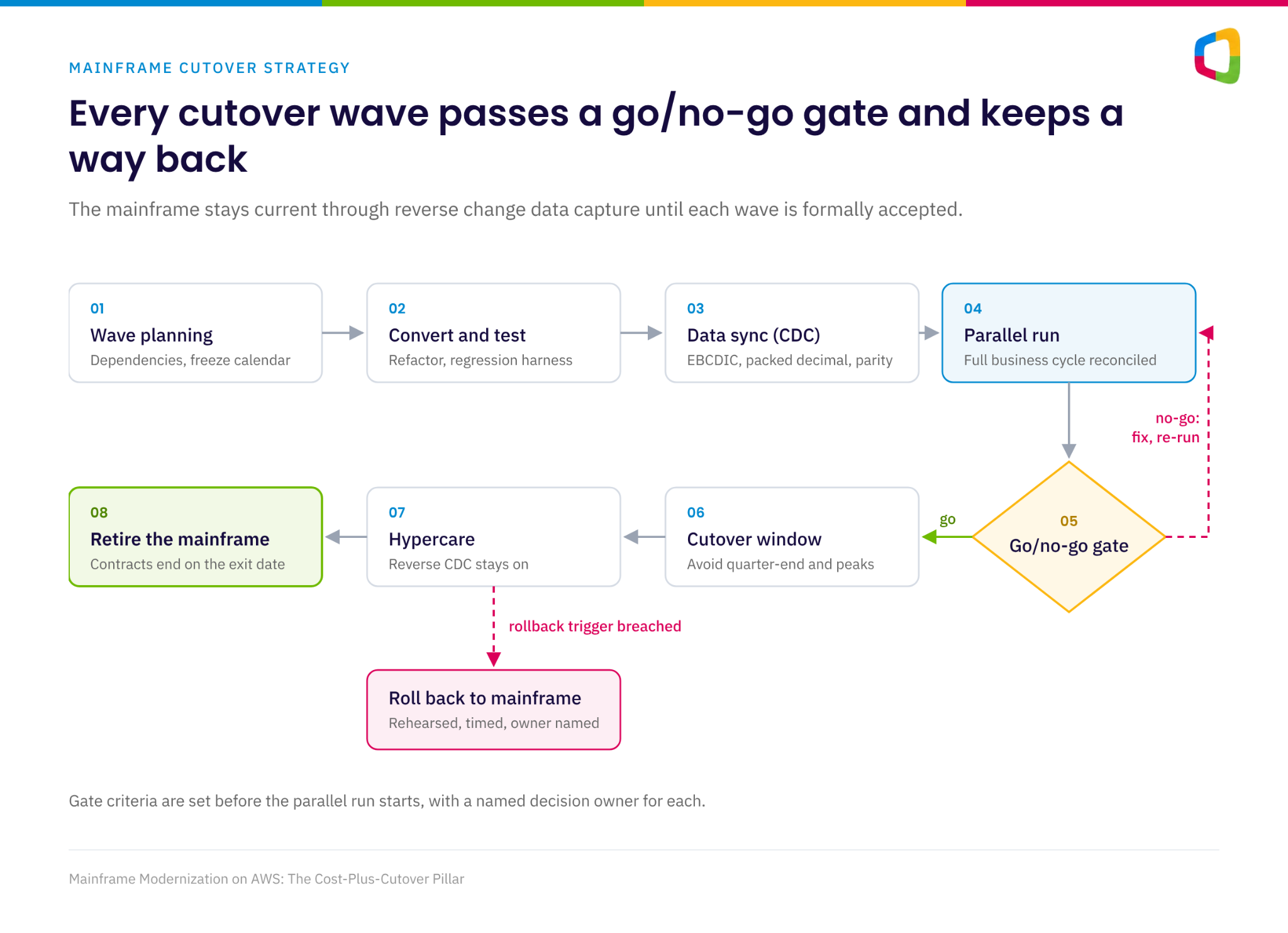

How should you plan a mainframe cutover strategy without taking the business offline?
The bank can't take its branches offline, so it would move in waves. Each wave keeps data in sync in both directions until it's accepted, and nothing switches over until it has cleared a go/no-go gate with measurable criteria. Whichever pattern you pick for a wave decides the cost, the downtime risk, and how much evidence you'll have for an auditor afterward.
|
Cutover pattern |
How it works |
Cost profile |
Downtime exposure |
Best fit |
|---|---|---|---|---|
|
Big bang |
All workloads switch in one window |
Lowest dual-run cost, highest recovery cost if it fails |
High, concentrated in one weekend |
Small estates with simple batch chains |
|
Phased waves |
Applications move in dependency-ordered groups |
Moderate, spread over months |
Low per wave |
Most mid-market and enterprise estates |
|
Full parallel run |
Both platforms process live input, outputs compared |
Highest dual-run cost, lowest residual risk |
Near zero |
Ledgers, payments, claims, anything an examiner will ask about |
|
Shadow run |
AWS processes replayed or sampled production input without serving users |
Moderate |
None during the run |
Read-heavy and reporting workloads |
|
Incremental API facade |
New services take over functions one at a time behind a routing layer |
Spread out, with longer coexistence |
Very low |
Reimagined systems and customer-facing channels |
At the bank, the reporting and inquiry workloads would go first, on a shadow run. Consumer loans would follow as their own wave. Deposits and the general ledger, which share that nightly batch chain, would move last and together, with a full parallel run across a quarter-end close.

Each wave runs through the same loop. A failed gate sends the wave back for fixes and another parallel cycle, and a breached rollback trigger during hypercare sends traffic back to the mainframe, which stays current through reverse change data capture until the wave is formally accepted.
We built our delivery model around gates like these. Agents do the repetitive analysis and a forward-deployed engineer makes the judgment calls. Nothing passes a phase exit without the customer's signature, so every go/no-go decision ends up written down with a name next to it.
Then there's the calendar. In the US, that means steering clear of quarter-end close, tax season if anything touches filings, open enrollment at health plans, and the run from Thanksgiving to Cyber Monday for retail and payments. European operations add year-end close and August, when a lot of people are on holiday. The worst week the bank could pick would be the one before a Call Report is due, since any reconciliation break that turned up late would leave it no time to recover.
How long should a parallel run last in a mainframe migration, and what should it prove?
A mainframe parallel run should go on until the workload has been through every business cycle it handles, at least once. For the bank's loan system, one month-end close would do. Its general ledger and regulatory reports need a quarter-end. A retailer or a tax processor would need its peak season too. We count the cycles first and turn them into weeks afterward.
Mainframe logic hides at the edges. Say the bank tested its deposit system for two weeks in the middle of a month and everything matched. Then month-end arrived. An interest accrual rule that only fires on the last business day ran on AWS for the first time, and 40,000 accounts came out a few cents off. Nobody had seen that rule in two weeks of testing, and the same goes for tax tables that change in January, leap-year paths, and the batch jobs that run once a quarter.
What the parallel run must prove, and the evidence your auditors and business owners will want to see:
|
What must be proven |
Evidence to collect |
Typical pass criterion |
|---|---|---|
|
Functional equivalence |
Automated output diffs for online transactions and batch files |
Zero unexplained differences, every break triaged and signed |
|
Data parity |
Record counts, hash totals, control totals per file and table |
Exact match after EBCDIC, packed decimal, and date conversions |
|
Batch performance |
Job start and end times against the batch window |
Critical path completes inside the window with agreed headroom |
|
Peak performance |
Response times and throughput at peak volume |
Meets or beats the mainframe service levels already in place |
|
Interface integrity |
Downstream file deliveries, API responses, partner feeds |
Every consumer confirms receipt and format |
|
Security and access |
Role mappings, privileged access logs, encryption settings |
Access review signed by the control owner |
|
Audit trail |
End-to-end lineage from source transaction to report |
An auditor can trace a sample transaction without engineering help |
This is where the cost trade-off comes in. A full dual run on live input gives you the strongest evidence, but both platforms run at production scale, so it's the most expensive option. Replaying production traffic in a shadow run costs less and suits read-heavy workloads. That's why many programs, the bank's included, use a full dual run for ledgers and payments and a shadow run for reporting and inquiry screens.
Ask about MAP early, too. AWS's Migration Acceleration Program runs a mainframe track that offers methodology guidance, investment incentives, and partner support. If you might qualify, it's far easier to fold into the parallel-run budget before the statement of work is signed.
What does a rollback plan look like when the mainframe is still your system of record?
For the bank's deposit wave, a rollback plan that works keeps the mainframe current through reverse data synchronization. It marks a point of no return, and it turns every trigger into a number with someone's name next to it. Leave one out and you end up arguing at 3 a.m. about whether to roll back, with the branches due to open at nine.
The criteria get agreed before the parallel run starts, so nobody can move the goalposts during the cutover window. For the bank's deposit wave, they'd look something like this:
|
Criterion |
Example threshold |
Decision owner |
If the threshold is missed |
|---|---|---|---|
|
Reconciliation breaks |
Zero unexplained breaks across the last full business cycle |
Business process owner |
Hold the wave, extend the parallel run |
|
Batch critical path |
Finishes inside the window on two consecutive peak runs |
Operations lead |
Tune and re-run before the gate |
|
Online response time |
At or below current mainframe service levels at peak |
Application owner |
Hold, scale, or optimize before go |
|
Downstream consumers |
All consumers confirm format and delivery |
Integration lead |
Hold until confirmed in writing |
|
Control evidence |
Access reviews, encryption, and logging signed |
Risk and compliance |
No go until signed |
|
Rollback rehearsal |
Full rollback executed in a lower environment within the agreed time |
Program lead |
No go until rehearsed |
We hold to four rules on every program. The rollback gets rehearsed with the same care as the cutover, run in full in a lower environment, with someone timing it against the real window. Reverse CDC keeps running through hypercare, so the mainframe stays a warm fallback until the wave is formally accepted. Everyone knows where the point of no return is: once downstream systems or customers depend on data that exists only on AWS, a rollback becomes a forward fix. And the reserve stays funded, with at least a month of mainframe run cost and enough contract flexibility to use it, until final acceptance.
That discipline is what made the difference for a branded-payments leader whose two earlier modernization attempts had stalled before cutover. Our write-up of that program sums up why the first two failed: "Discovery eats the budget; cutover gets de-funded." The third attempt delivered a PCI DSS-aligned, cloud-native AWS platform with no audit incident during cutover.

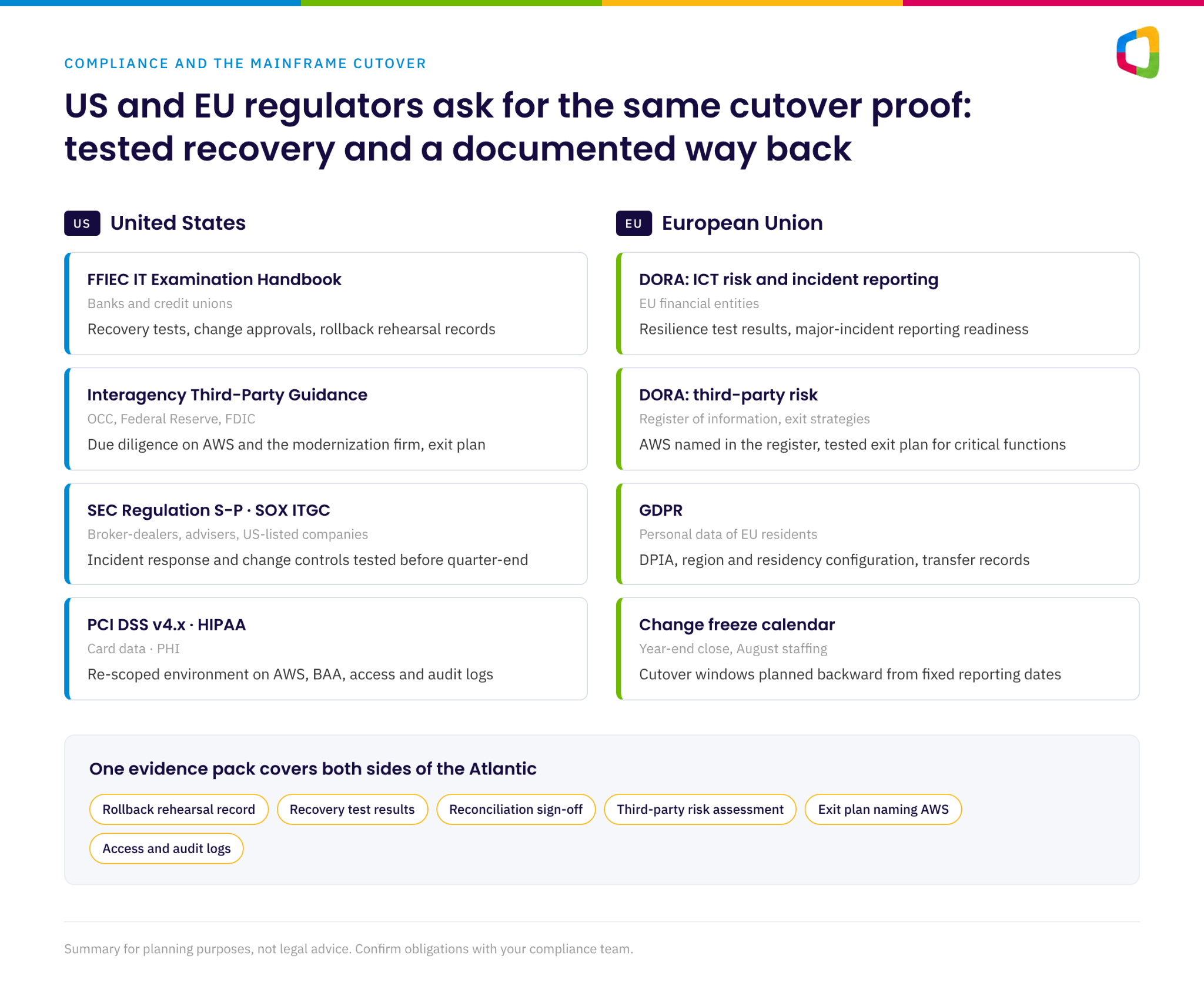

Which compliance requirements shape a mainframe cutover for US and European enterprises?
The bank's compliance team would ask three questions about the cutover. What evidence do we need before go-live? Which weeks are we allowed to switch in? And can we prove we'd get back if something broke? On both sides of the Atlantic, operational resilience and third-party oversight are now exam topics in their own right, so the bank's answers would go straight into its compliance file.
|
Framework |
Who it applies to |
What an examiner will ask |
What we'd show them |
|---|---|---|---|
|
FFIEC IT Examination Handbook |
US banks and credit unions |
Show me a recovery test on the new platform, and who approved the changes. |
The AWS recovery test, signed change approvals, the rollback rehearsal log |
|
Interagency Guidance on Third-Party Relationships |
US banking organizations |
What did you check before hiring AWS and your modernization firm, and how would you leave them? |
Our third-party risk assessments, the contracts, the exit plan |
|
SEC Regulation S-P (as amended) |
Broker-dealers, investment advisers, and other covered firms |
If the new platform has an incident, does your response plan cover it, and will your providers tell you within 72 hours? |
The updated incident response program and vendor oversight records |
|
SOX IT general controls |
US-listed companies |
Were change and access controls on the AWS environment tested before quarter-end? |
ITGC walkthroughs and test results from the AWS environment |
|
PCI DSS v4.x |
Anyone storing, processing, or transmitting card data |
What's in scope on AWS now, and are the requirements that took effect in March 2025 in place? |
The scoping document, segmentation test results, our targeted risk analyses |
|
HIPAA Security Rule |
Covered entities and business associates |
Did the BAA and the updated risk analysis come before the first PHI moved? |
Updated risk analysis, BAA, and access and audit logs |
|
EU DORA |
EU financial entities |
Is AWS in your register of information, and have you tested the exit strategy for critical functions? |
Register of information, exit plan, and resilience test results |
|
GDPR |
Any organization processing EU residents' personal data |
Where does the data live now, how does it get transferred, and can I see the DPIA? |
DPIA, region and residency configuration, and transfer records |
For US institutions, the hard part is usually timing, and that's what we see across our financial services programs. Exams, quarter-end SOX testing, and card network deadlines all fall on fixed dates. At the bank, a deposit cutover that slipped from March to May would land its new-platform evidence in the middle of an exam cycle planned around the old system. So we plan the freeze calendar backward from those dates and fit the parallel run inside it. The cost of getting it wrong is concrete: IBM's 2026 Cost of a Data Breach Report puts the average financial services breach at $6.29 million, second only to healthcare, against a global average of $4.99 million.

In Europe, DORA has made resilience something you report on. In 2025, EU financial entities reported 3,383 major ICT-related incidents, according to the first DORA report from the European Supervisory Authorities. Half of them came down to system failures or malfunctions, and a botched cutover is exactly that. So we treat a rehearsed rollback and a tested exit plan as compliance deliverables, not engineering extras. Since November 2025, AWS has also been on the ESAs' list of designated critical ICT third-party providers, as Amazon Web Services EMEA SARL, so your register of information and exit strategy should name it.
Healthcare and life sciences organizations face the same logic under HIPAA. PHI can't sit half-migrated without access controls and audit logging on both sides. Our healthcare data platform work retires legacy systems on schedule, with data movement and access events traceable to source for audit teams.
Can AI agents convert COBOL to Java on AWS accurately enough for production?
They can, if they don't work alone. On the programs we run, agents sit inside a deterministic pipeline, with regression tests checking every change and an engineer owning each judgment call. A general-purpose model left to do the whole job gets less accurate as programs get more complex, and the parallel run is where you'd find out.
The research points the same way. In a 2026 arXiv study, GPT-4o produced compilable COBOL on only 41.8% of COBOLEval tasks, and just 16.4% passed their tests on the first try, while a domain-adapted model, COBOL-Coder, reached 73.95% compilation success. Practitioners are cautious too. Of 61 surveyed for a paper at ESEM 2026, 62.3% were happy to use LLMs for single-file migration most of the time or almost always, but only 4.9% would say that about a whole project. And in BMC's 2026 mainframe survey, 40% of respondents would let AI recommend code-management actions, while only 23% would let it carry them out.
So agents are very good at the volume work, and what's left of the risk sits in a smaller set of complex programs, cross-program dependencies, and data edge cases. That's where you want your senior engineers, and it's where the cutover gets decided. For the bank, that means the interest calculations and a few hundred Assembler routines. The hundreds of CICS screens that just read and update records are the easy part.
|
Task |
Agents would take on |
The bank's engineers would keep |
|---|---|---|
|
Discovery and inventory |
The 4 million lines of COBOL, with their JCL, copybooks, and dependencies |
Where one wave ends and the next begins |
|
Code conversion |
Most of the deposit and loan code, plus a write-up of its business rules |
The interest calculations, the Assembler, anything performance-critical |
|
Data migration |
Db2 and VSAM schema maps, conversion scripts, lineage |
The target data model and where it lives |
|
Testing |
Test cases, nightly output diffs, the regression harness |
What counts as accepted, and the business sign-off |
|
Cutover |
Rehearsal scripts and reconciliation reports |
Go or no-go, roll back or not, and keeping branches and finance on board |
Fixed fee, time and materials, or outcome-based: how should you buy mainframe modernization services?
Here's how the bank's contracts would change over the program. Discovery would be time and materials, because nobody could price a scope that moved every week. After that, each of the three waves would get a fixed date and a fixed fee that fit the 20-month exit. The contract would also need a clause naming who pays when a date slips, and how each phase gets signed off. Put simply, the risk sits with whoever controls it.
|
Commercial model |
Who carries delay risk |
Where it fits |
What to insist on |
|---|---|---|---|
|
Time and materials |
You |
Discovery and early assessment |
Phase caps, weekly burn reporting, named staff |
|
Fixed fee |
The provider for scope, you for change requests |
Well-defined waves |
Written acceptance criteria and clear test ownership |
|
Fixed date and fixed fee |
Whoever caused the delay |
Programs with a hard contract or regulatory date |
A clause that assigns each delay, overage terms, and a signature on every phase |
|
Outcome-based |
Shared |
Results you can measure, like the mainframe off by a set date |
A baseline you both agree on, and how you'll measure against it |
Whatever the model, read the scope line by line. Cutover, hypercare, rollback rehearsal, and the mainframe switch-off should all be inside the fee. A proposal that stops at "code delivered to UAT" leaves the most expensive weeks of the program outside the price, and that is where change orders tend to appear.
One more point for CFOs. A fixed fee only has teeth if the provider's delivery economics make it sustainable. A firm that bills by the hour has every reason to add people when a program runs long. If most of the delivery runs on agents, an extra validation cycle costs the provider very little, and that's what makes committing to a date possible.
What should you ask a mainframe modernization partner before you sign?
If the bank were choosing a partner, we'd tell its CFO to get three things proven before signing: that the people scoping the work will run the cutover, that the cutover is in the price, and that the partner has named customers running in production on AWS today. Here's how that test might play out.
Say the bank put three firms through that test. The first couldn't promise that the engineers in the pitch would still be there on the cutover weekend. The second firm's fee stopped at UAT, with hypercare, rollback rehearsal, and the mainframe switch-off marked "to be scoped." Only the third could say who'd write the test cases and sign off that the new system behaved like the old one, what would happen to its fee if it caused a slip, and when each wave's rollback would be rehearsed.
The bank would still have a few questions for that third firm: how much of the work agents would do and how many hours that saves against a traditional proposal, how an auditor could trace an automated decision back to source, and which AWS competencies and service validations the team holds for migration and modernization.
Last, and most important, it would ask to speak to a named customer whose cutover looked like its own, and find out where they started, what changed, and how long the value took to arrive.
FAQs
What is mainframe modernization on AWS?
How much does it cost to migrate a mainframe to AWS?
How long does a mainframe migration to AWS take?
As long as your contracts allow, in most cases. The bank's hardware lease and ISV renewals fall 20 months out, and that's the date its whole plan would be built backward from. Agents now finish discovery and wave planning in weeks. Each of the bank's three waves would then take its turn through conversion, testing, a parallel run sized to business cycles, cutover, and hypercare, with an exit date for every wave written into a fixed-date contract.
Is AWS Transform for mainframe free?
The code transformation is. Since March 2026, AWS Transform for mainframe refactor has charged nothing for it, replacing the old lines-of-code pricing. You still pay for the runtime the refactored applications run on, the rest of the AWS infrastructure, and the testing, data migration, parallel running, and engineering work around the cutover. AWS also notes that future capabilities may be paid, so check the pricing page before you budget.
Should I rehost or refactor my mainframe on AWS?
How do you cut over from a mainframe to AWS without downtime?
By never switching everything at once. The bank's deposit wave, for example, would keep both platforms in sync through change data capture and run them side by side until a full quarter-end reconciled. Only then would it pass the go/no-go gate, with a rehearsed rollback ready and reverse synchronization keeping the mainframe current through hypercare. The branches wouldn't notice the switch.
How long should a mainframe parallel run last?
Long enough for the workload to go through every business cycle it handles, at least once. For most transactional systems, that's at least one month-end close. General ledgers and regulatory reporting usually need a quarter-end, and seasonal businesses should get through their peak before anyone makes the go/no-go call. The bank's deposit and ledger wave would run in parallel across a full quarter for exactly that reason.
Does the AWS Migration Acceleration Program fund mainframe migration?
It can help. MAP has a mainframe track that combines methodology guidance, investment incentives, and partner support, and what you get depends on the program's scope and expected AWS consumption. Bring it up before the statement of work is signed, while the assessment budget and the parallel-run costs are still being worked out.
We're an EU financial entity. What does DORA require when we move off the mainframe?
What do US bank examiners expect when core systems move to AWS?
Can COBOL be converted to Java automatically on AWS?
Written by
Kaja Hussain
Sr. FDE in Database and Application Modernization, Mactores
On each engagement, Kaja sets up the AI agents that convert schemas and stored procedures. He then checks their output for logic that translates cleanly but behaves differently once it runs. He tests query plans against real workloads under the PostgreSQL optimiser and plans cutovers so the application stays online throughout. He writes about where agent-led migrations hold up and where they still need an FDE's judgement.
Let's deliver
Bring us the process. We will bring the authority model.
The agent-native AWS modernization firm. Data platforms moved. Legacy retired. AI agents in production. AWS Premier Tier Services Partner since 2026, on AWS since 2008.
- 01 AWS Premier Tier Services Partner, on AWS since 2008.
- 02 Forward-deployed engineers own architecture, cutover and the date.
- 03 Acceptance criteria per phase, with the signer named in the SOW.
- 04 The golden set and the trace data belong to you.
