Application Modernization: The Decision, the Sequence, and the Cost

Legacy application stack separating into independent modernized modules

Key takeaways

  • System age is a weak readiness signal. Rising change latency, a one-engineer dependency, and a renewal bigger than the rebuild say far more.
  • The binding constraint picks the disposition. A data-centre exit points to rehost and a licensing renewal to replatform, decided system by system.
  • The database usually holds more business logic than the code. That is why the application and the schema belong in one assessment.
  • Three artifacts decide whether a cutover lands. A written cutover criterion, a rehearsed rollback, and a dated retirement for the legacy system.
  • Application modernization estimates slip in discovery, not the build. A separately paid assessment whose outputs you keep makes that risk visible early.
  • Four measures hold up in front of a board. Change latency, change failure rate, reallocated run cost, and the constraint the program cleared.

Definition

Application modernization is any change to a production system's runtime, data layer, or architecture that reduces the cost of the next change. Lifting a legacy app onto cloud VMs is the easy part, and on its own only a hosting change. The harder part is deciding which systems to change, in what order, and at what cost. This guide covers all three.



Application modernization is the work of changing what a system runs on without changing what the business depends on it for. That sentence is simple to write and hard to execute, which is why most programs fail on sequencing rather than on technology. The engineering is usually solvable. The decision about which systems to touch, in what order, against which constraint, and with what evidence at cutover is where multi-year overruns begin.

This guide is vendor-neutral. It carries no product recommendation, no platform preference, and no maturity-model pyramid. It covers the questions an application owner has to answer before signing anything, the trade-offs sitting behind each answer, and the failure modes that surface eighteen months later, once nobody remembers why a choice was made.

What application modernization actually means

The term has been stretched to cover everything from a hosting change to a full rewrite, which is precisely why budgets attached to it are so hard to defend. A narrower working definition helps. Modernization is any change to a production system’s runtime, data layer, or architecture that reduces the cost of the next change.

The test is forward-looking. Moving a monolith to a cloud VM and leaving it untouched is a hosting change, and it lowers a facilities line and nothing else. Splitting that monolith’s billing logic into a service with its own schema and its own deploy pipeline counts as modernization, because the next change to billing no longer requires a full-system regression cycle.

What often gets billed as modernization

Work item

What it actually is

Does it lower the cost of the next change?

Lift-and-shift to cloud VMs

Infrastructure migration

No. The same code runs on someone else’s hardware.

Version upgrade of a database engine

Maintenance

Rarely. It buys a support window rather than flexibility.

Wrapping a legacy system in an API

Integration

Partially. Access improves while the core stays intact.

Replacing a custom system with SaaS

Portfolio change

Yes, provided the process bends to the product.

Refactoring into services with independent data

Modernization

Yes.

Re-architecting around an event or streaming model

Modernization

Yes, at the highest cost and the highest risk.

Naming the work honestly matters for a practical reason. A CFO who approves modernization and receives an infrastructure migration will decline the second phase. Most stalled programs stalled exactly there.

The five signals a system is genuinely ready

Age is a weak proxy for application modernization urgency. Systems written in 2004 that are well tested, well documented, and rarely changed can sit safely for another decade. Systems written in 2019 that nobody will touch without the one engineer who understands them cannot. The reliable signals are behavioral.

Signal 1: Change latency is rising while change volume stays flat

The same class of change takes longer each year. This is the single most reliable indicator, because it measures accumulated coupling directly instead of inferring it from an architecture diagram.

Signal 2: One person is required for any material change

A single engineer, or a small group, has to be in the room before anything significant ships. Treat this as a line on the risk register with a named owner and a mitigation date attached to it.

Signal 3: The renewal is larger than the rebuild

Licensing, extended support, and specialist maintenance accumulate on a system that delivers no competitive differentiation. Once the run cost of standing still approaches the cost of moving, the decision becomes arithmetic.

Signal 4: The system blocks a program that is already funded

Analytics, AI, a partner integration, or a new compliance regime cannot proceed until the legacy system changes. The board has already approved that spend, and the legacy system now stands between the approval and the delivery.

Signal 5: Compliance evidence has to be reassembled after the fact

Audit responses require someone to reconstruct what happened from logs and memory. The architecture is failing a governance requirement, and every new regulation compounds the failure.

How to read the signals together

One signal on its own usually argues for containment. Freeze the interface, stop investing, and plan a window for later. Three or more argues for scheduling the work. Five argues for scheduling it inside this fiscal year.

Seven dispositions, and how to choose between them

Most application modernization conversations collapse into a binary of migrate or rewrite. The useful frame applies a disposition per system across the portfolio. A typical estate ends up running four or five different dispositions in parallel, and that is the correct outcome.

The disposition matrix

Disposition

What you do

Best fit

Typical risk

What it costs you later

Retain

Leave it in place and freeze investment

Stable, low-change systems that block nothing

Low today, rising each year

The cost is deferred, and it still arrives

Retire

Decommission and migrate the residual data

Overlapping systems and dead features

Low, provided actual usage is understood

Nothing, if the usage analysis was right

Rehost

Move the runtime with no code change

A data-centre exit under a hard deadline

Low technically, high strategically

The full cost of the real work, later

Replatform

Move and swap components such as the database engine, app server, or runtime

Licensing pressure and managed-service targets

Moderate, because behavioral differences surface under load

Some architectural debt survives

Refactor

Restructure code and data in place

A sound domain model inside poor structure

Moderate, with a long parallel-run window

The least residual debt per unit of spend

Rearchitect

Build a new architecture for the same capability

Systems acting as a permanent constraint

High, because scope tends to expand

Nothing if it lands, everything if it stalls

Replace

Buy a product and retire the custom system

Capabilities that carry no differentiation

Moderate to high, driven by process change

Configuration debt and vendor dependency

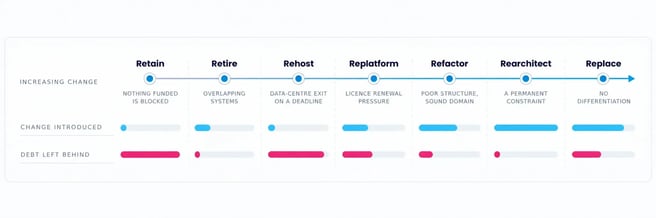

Seven application modernization dispositions ranked by how much change each introduces

Two rules govern the table.

Rule 1: Choose against the binding constraint

If the binding constraint is a data-centre lease expiring in nine months, rehost is the right answer even when it is the least satisfying one. If the constraint is a licensing renewal, replatform is right. If the constraint is a funded AI program that cannot read the data, rearchitecting the data layer comes first and the application layer waits. The common failure is choosing the disposition that matches the ambition, then meeting the constraint mid-flight.

Rule 2: Sequenced dispositions need a trigger in writing

“Rehost now, refactor in year two” becomes a real plan once year two has a named owner, a budget line, and a written trigger condition. Without all three it is a rehost with a story attached, and the second phase quietly disappears. Ask for the trigger condition in writing before approving phase one.

The database is the dependency most programs under-scope

Application modernization plans are usually written by application people, and the database arrives late in the analysis as an implementation detail. In most legacy estates the data layer holds more business logic than the application code does, spread across stored procedures, triggers, constraints, scheduled jobs, and views that some quarterly report has depended on for a decade. Three consequences follow, and each one turns into schedule slip when it surfaces during build instead of during assessment.

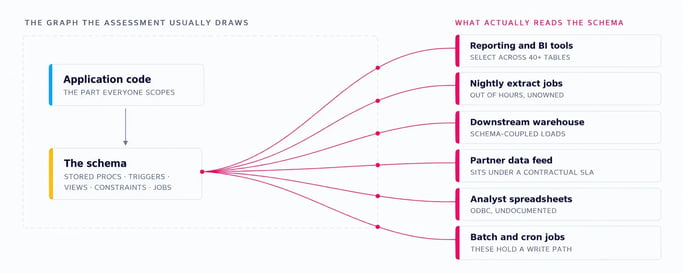

Six systems outside the assessment boundary reading the legacy database schema directly

Behavior hides where a code search cannot reach it

Transaction isolation, cursor semantics, collation and sort order, null handling, implicit type conversion, and date arithmetic all behave differently between database engines, and they differ in ways that throw no errors. They simply return different answers. A test suite written against the application will pass while the numbers quietly change underneath it.

The blast radius extends past the application boundary

Reporting tools, extract jobs, downstream warehouses, partner feeds, and spreadsheets on somebody’s laptop all read the schema directly. The application’s dependency graph and the schema’s dependency graph are two different graphs, and only one of them usually gets drawn.

Cutover risk concentrates in the data

Rolling back an application is a deployment operation. Rolling back data after hours of production writes is a reconciliation project with a timeline of its own. That asymmetry is the reason cutover planning should start at the data path and work outward from there.

What this means in practice

Assess the application and the database together, in one pass, against one dependency graph. Splitting them into two workstreams under two owners is the most reliable way to produce a plan that is internally consistent and externally wrong. Mactores scopes both layers as a single engagement for exactly that reason, and the assessment produces a single graph covering the application and the schema together.

Sequencing is the part that decides whether it lands

Once the disposition is set, sequencing decides the outcome of an application modernization program more than tooling does. Four patterns cover nearly all production work.

Strangler

Route traffic through a facade, move capability behind it incrementally, and retire the original once the last route is redirected. It carries the lowest risk and the longest calendar. It is also the pattern most often abandoned around seventy percent complete, which leaves two systems, two on-call rotations, and a permanent operating cost. If you choose it, name the retirement date at the start and defend it.

Parallel run

Both systems process real production traffic, outputs are compared continuously, and the legacy system stays authoritative until agreement holds at a defined threshold. This produces the strongest evidence available for regulated or financially material workloads, and it is also the most expensive pattern to operate. Parallel runs fail when nobody defines the exit criterion, so they run indefinitely and quietly become the plan.

Phased cutover by domain

Move one bounded domain completely, including its code, its data, and its consumers, then move the next. The pattern requires clean domain boundaries, which is exactly what legacy systems lack, so the first phase absorbs a disproportionate share of the cost while those boundaries get established.

Big-bang cutover

Everything moves in a single window. The pattern is correct more often than its reputation suggests, specifically when the system is small, when a parallel run is genuinely infeasible, or when partial states cannot be reconciled. It requires a rollback that has been rehearsed against production-like data and volume. A rollback that exists only as a document has never been tested.

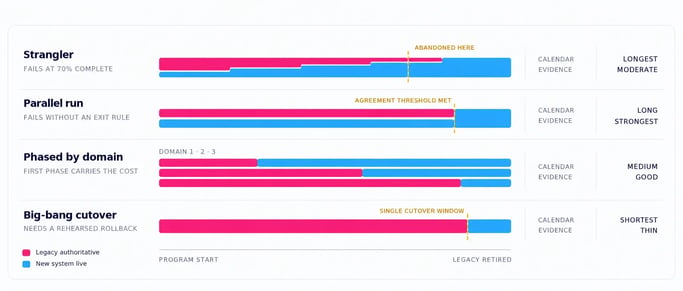

Four cutover sequencing patterns compared on calendar length, evidence strength and failure point

Three artifacts to confirm before build starts

Whatever the pattern, ask whether these three exist.

  • A written cutover criterion. “When testing is complete” will not do. State the threshold: reconciliation variance under a defined tolerance across a defined period, with a named person who signs.
  • A rehearsed rollback. Execute it at least once against production-like data and volume, and record the result. An untested rollback plan functions as a control only on paper.
  • A retirement date for the legacy system. Write it into the plan with a budget line that disappears on that date. Systems kept running for safety tend to keep running forever, and the savings case never arrives.

What application modernization costs, and why the estimate slips

Application modernization estimates fail predictably. The build is estimable. The discovery is not, because the unknown is by definition unscoped, and the commercial model decides who absorbs that gap.

How the commercial models compare

Model

Who carries discovery risk

Best fit

Failure mode

Time and materials

The customer

Genuinely exploratory work

A change-order spiral, with the incentive misaligned against finishing

Fixed-fee, fixed-date

The vendor

Well-bounded scope after a real assessment

Scope defended narrowly, and ambiguity turns into dispute

Outcome-based

Shared

A single measurable business metric

Attribution arguments over what actually moved the metric

In-house

The customer

Deep domain knowledge and available capacity

Opportunity cost, because the product roadmap stops

Three structural points hold regardless of the model you choose.

Pay for assessment separately and own the output

A discovery sprint that produces a dependency graph, a disposition recommendation per system, and a cutover risk register is worth buying on its own. Contract it so that you keep the artifacts whether or not the same firm does the build. A vendor who declines to sell assessment as a standalone deliverable is selling a sales instrument.

A fixed fee means little without overage terms

A fixed fee with unlimited change orders is time and materials with a cover page. Ask one direct question: what happens to the fee if the date slips for reasons inside the vendor’s control? The answer separates a delivery commitment from a pricing format.

Budget the run cost of the transition

Parallel runs, dual licensing, two on-call rotations, and duplicated infrastructure cost real money for the whole transition period. Programs that omit this line discover it in month four and cut the parallel run short, which is the moment risk actually enters the system.

How to measure it so the result survives board scrutiny

Application modernization is easy to declare done and hard to prove valuable. Four measures hold up under scrutiny, because each one has a baseline that predates the program.

Change latency

Median time from committed change to production, for a defined class of change. Capture the baseline before the program starts. It expresses the definition at the top of this piece more cleanly than any other number available.

Change failure rate

The percentage of changes that require remediation. A program that improves speed while degrading this number has relocated the cost instead of removing it.

Reallocated run cost

Licensing, maintenance, and specialist support that stopped, with the receiving budget line named. Savings without a stated destination will not survive a finance review.

Constraint cleared

The funded program that could not proceed, and the date it actually started. This measure is binary, dated, and the one executives remember a year later.

What to leave out of the report

Lines of code migrated, services created, and percentage complete all measure activity. Every one of them can rise while the four measures above get worse.

What changed in 2026

Two things have shifted in application modernization, and both are worth stating carefully, because the market currently overstates both.

Automation has absorbed the analysis layer

Dependency mapping, call-graph construction, dead-code identification, test generation, and parallel-run instrumentation are mechanical tasks, and agent tooling now completes them faster and more thoroughly than an analyst team does.

That genuinely changes the unit economics of assessment, and it compresses the phase that used to consume the most calendar time. The judgment layer has not moved. Which disposition fits which system, where a domain boundary belongs, how to sequence a cutover against business risk, and when the evidence is sufficient to sign all remain human decisions. Any tool claiming to automate that layer is describing a roadmap.

The AI program now prices the cost of waiting

For most organizations, the binding constraint on putting AI into real operations sits in the systems of record, which cannot be read, grounded against, or written to safely. Model access stopped being the bottleneck some time ago. This moves modernization out of the infrastructure budget and into the capital-allocation conversation, which changes who approves it and on what timeline. It also raises the standard, because a modernization that delivers a cloud-hosted version of the same opacity has not cleared the constraint.

How to evaluate an application modernization partner

Five questions, each with a wrong answer that is easy to spot.

1. Who runs the assessment, and do they run the build?

A firm that scopes the work and then hands it to a separate delivery organization has no incentive to scope honestly. Ask whether the people in the assessment sessions will be the people in the room at cutover.

2. What happens to the fee if the date slips?

Every firm commits to a date, so the commitment on its own tells you nothing. Ask who pays when the date moves.

3. What does acceptance look like in writing?

You want a named artifact, a named signer, and a defined criterion for each phase exit. “Sign-off on completion of the phase” fails all three tests.

4. Show me a cutover that went wrong

Any firm with production history has one. How they answer tells you how they behave under pressure, which is the thing you most need to know.

5. Who runs the system the day after?

If the answer is a managed-service agreement, you have replaced one dependency with another. The target state has your team owning a system they can change themselves.

The short version

Application modernization is a sequencing problem wearing a technology costume. Diagnose the system by its behavior and treat age as a weak proxy. Choose the disposition that answers your binding constraint.

Scope the database in the same pass as the application. Write the cutover criterion, rehearse the rollback, and put a retirement date on the legacy system. Measure change latency, change failure rate, reallocated cost, and the constraint you cleared. Ask the vendor who pays when the date moves.

Do those things and the engineering, which was always the solvable part, stays solvable.



Frequently Asked Questions

Who should own an application modernization program internally?

Ownership works best with a single accountable executive who controls the legacy run budget and the modernization budget together. When those two budgets sit with different people, the retirement decision has no owner and the legacy system survives its own replacement. The delivery lead can sit inside engineering, but the person who signs the retirement date needs authority over the line item that disappears on it.

How do we build the business case when the savings land in a different budget than the cost?

Name the receiving line before the program starts and have the receiving owner sign the number. Most application modernization business cases weaken in year two, when a licensing line was retired but nobody claimed the saving, so it surfaces as a cost avoided that no budget can point to. Write the transfer into the plan the same way you write the cutover date.

What happens to the team that maintains the legacy system?

Plan for it explicitly, because the people who understand the legacy system are the same people the assessment depends on. Teams that come through this well move into ownership of the new platform, and they are told so early. Where that conversation gets avoided, knowledge transfer slows in ways that are hard to attribute and expensive to fix.

Can an application modernization program run while the feature roadmap continues?

Yes, and the binding constraint is usually review capacity rather than engineering capacity. Domain experts have to validate business rules, approve reconciliation results, and sign phase exits, and those people are typically the ones the roadmap also depends on. Model their time explicitly during planning and treat it as a scarce resource with a named allocation.

How do we handle a system whose original requirements were never written down?

Treat the running system as the specification and capture its behavior empirically. Production traffic replay, output comparison, and reconciliation against real volumes describe what the system does today far more accurately than a document written a decade ago. This is the strongest argument for a parallel run in systems where the requirements are effectively lost.

Which contract terms matter most in an application modernization SOW?

Four terms carry most of the weight: who owns the assessment artifacts, what acceptance means at each phase exit and who signs it, what happens to the fee when the date slips for reasons inside the vendor’s control, and what the exit provisions are if the program stops early. Price is usually the term teams negotiate hardest and the one that predicts the outcome least.

How do we keep auditors comfortable through a cutover?

Bring them into the design of the evidence instead of the review of it. Agree in advance on what the parallel run will produce, what tolerance counts as agreement, how long the comparison window runs, and where the evidence is stored. Audit findings during modernization usually trace back to evidence that was reconstructed afterwards, so capturing it at decision time removes most of the exposure.

When is the right answer to leave the system alone?

When it is stable, rarely changed, understood by more than one person, blocking nothing that is funded, and carrying a renewal cost the business can absorb. Containment is a legitimate disposition. Freeze the interface, stop investing in the system, and set a review date. The mistake is treating containment as permanent and letting the review date pass unnoticed.



Kaja Hussain, Sr. FDE in Database and Application Modernization, Mactores

Written by

Kaja Hussain

Sr. FDE in Database and Application Modernization, Mactores

Kaja is a Sr. FDE in Database and Application Modernization at Mactores. He works with customer teams and uses AI agents to move databases, and the applications built on them, from SQL Server and Oracle onto Aurora PostgreSQL.

On each engagement, Kaja sets up the AI agents that convert schemas and stored procedures. He then checks their output for logic that translates cleanly but behaves differently once it runs. He tests query plans against real workloads under the PostgreSQL optimiser and plans cutovers so the application stays online throughout. He writes about where agent-led migrations hold up and where they still need an FDE's judgement.
